183 BESS Delivered from China to Bulgaria in 30 Days

Chartered vessel from China to Bulgaria | DG cargo (UN 3536) | Full inland execution.

BESS cargo logistics project

Planning a BESS project? Choose the right logistics model from day one.

Energy Infrastructure. Executed for Over Three Decades.

For more than 30 years, Unimasters has been delivering complex energy and project cargo across Bulgaria and the region.

Battery Energy Storage Systems are not a new segment for us. They are the next chapter in an energy transition we have supported for decades.

See one of our latest projects in action

Discover how Unimasters successfully transported BESS cargo from China to Bulgaria, ensuring full compliance, safety and multimodal coordination.

Case Study: 183 BESS Units. China to Bulgaria. 30 Days.

When time, regulatory compliance, and cargo sensitivity intersect, logistics becomes a strategic decision. Here is how we executed the project.

The Challenge

183 Battery Energy Storage Systems

Heavy containers (35–45 tons)

DG cargo classification

Strict deadline

Limited carrier acceptance

Risk of storage penalties

Commissioning timeline was critical.

The Solution

Chartered a dedicated vessel

Routed via Suez

Coordinated origin & DG documentation

Managed port handling in Varna

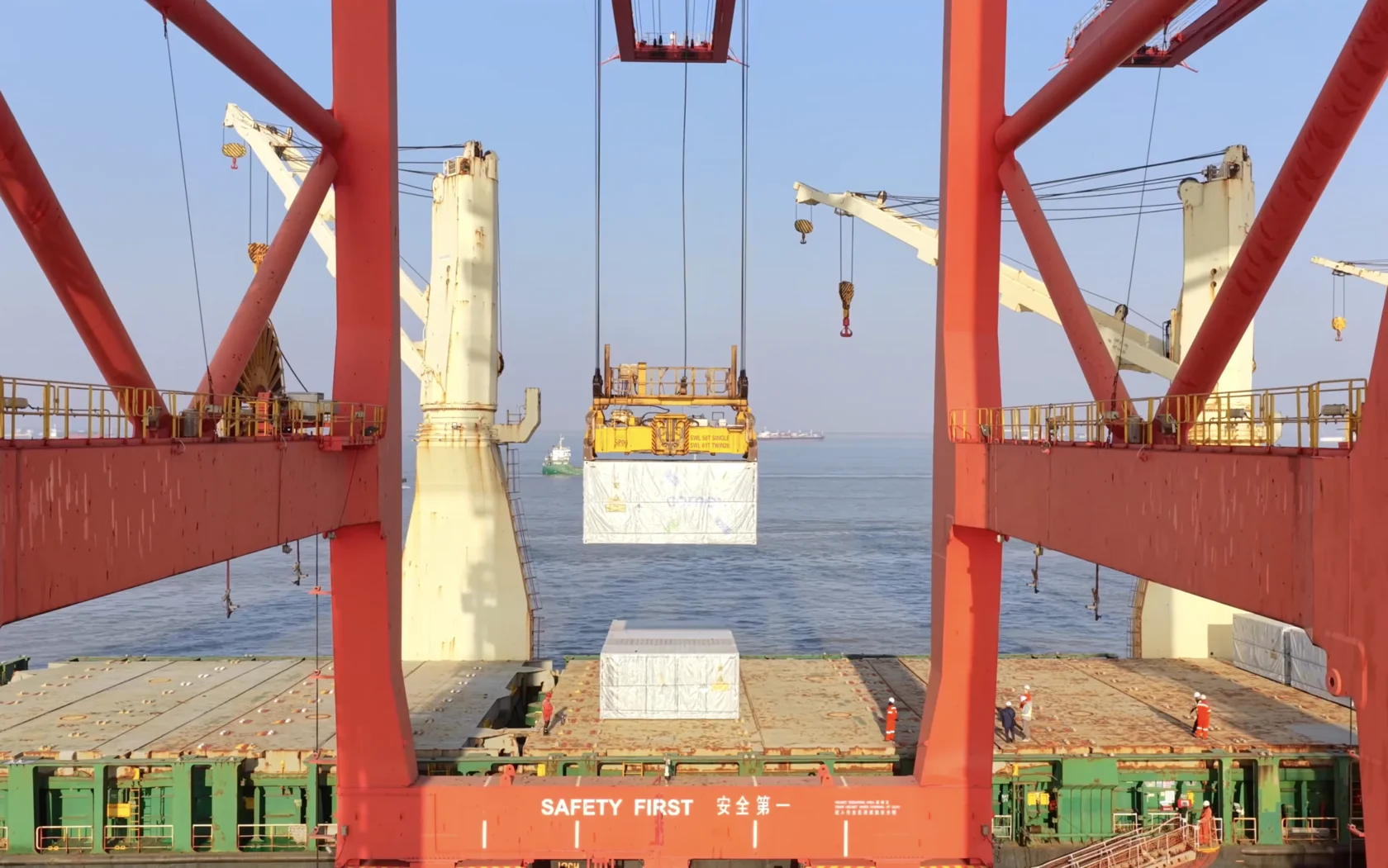

Executed inland ADR transport to final site

Risk of storage penalties

Result: Delivered on time. No storage costs. Full operational control.

Which BESS Scenario Are You In?

Every BESS project is different. Your logistics strategy should be too.

Charter Vessel Strategy

Full capacity control. Fastest routing. Best for commissioning-critical projects.

BESS logistics operations

Why BESS logistics is different?

Battery energy cargo is not standard freight. It requires:

UN 3480 / 3481 / 3536 compliance

DG + project cargo integration

Carrier-specific approvals

State-of-charge documentation

Strict commissioning alignment

What Unimasters Controls?

We control the full logistics chain - from factory gate in Asia to energy park in Bulgaria.

Carrier & DG pre-approval before booking

Routing optimisation for Bulgaria & region

Port handling & customs execution

Heavy / ADR inland transport

Single accountable partner

BESS project transport

Not sure which model fits your project?

Request a preliminary routing and budget assessment.

Get Expert Review

Why Engage Early?

Early logistics involvement ensures:

Accurate logistics CAPEX budgeting

Faster permitting

Reduced delay risk

Optimised routing during project design

Planning a BESS project in Bulgaria or Europe?

Let’s define the right logistics strategy before shipment planning begins.

By clicking “Request BESS Logistics Review” you agree with our

General Terms,Privacy Policy

and

Cookie Policy.
Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

Phone

Miroslav

+359887921173

Phone

Iliyana

+359884234599

Phone

Plamena

+359888797151

Project Cargo | DG Logistics | Multimodal | Customs

Unimasters - your logistics partner for battery energy infrastructure.
